SPVs

CUSTOMER SATISFACTION
VALUE CREATION

NATION BUILDING

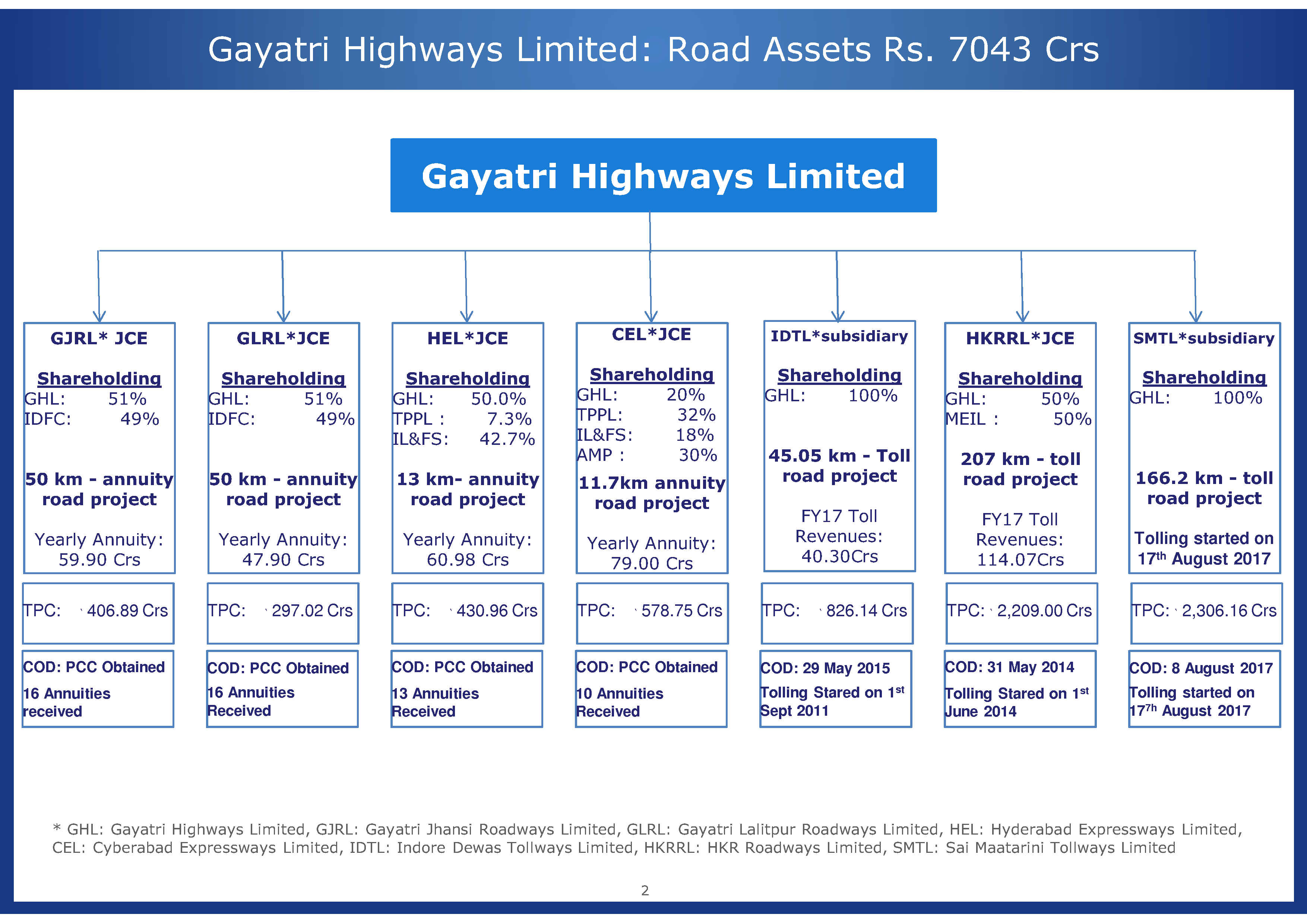

We are at present operating 7 BOT projects. The details are as under:

Gayatri Lalitpur Roadways Ltd

Gayatri Lalitpur Roadways Ltd. GLRL is a Special Purpose Company, annuity BOT project which GPL bagged with consortium company Infrastructure Development Finance Company Ltd (IDFC). The project involves to design, develop, construct, operate and maintain of 50 km stretch between Jhansi and Lalitpur on National Highway no. 26 (NH‐26) as part of the North – South Corridor in Uttar Pradesh. The work involves strengthening and widening of existing 2 lane highway, construction of additional 2 lanes and provision of service roads in specific urban and semi‐urban areas to cater to local traffic. Total cost of project is Rs.2,970 mn which enjoys 20 years of concession period including construction period of 30 months. The project has commenced operations from FY11.

Final COD : The final completion certificate is issued by the indipendent consultant vide their letter dated 13th Novermber, 2017. The final completion date is 19th March, 2012

Major Maintenance Work : 1st Major Maintenance Work was completed in June, 2017 and completion certificate in this regard is issued by independent consultant.

Gayatri Jhansi Roadways Ltd

Gayatri Jhansi Roadways Ltd. GJRL is annuity BOT project which GPL bagged with consortium company Infrastructure Development Finance Company Ltd. The project involves to design, develop, construct, operate and maintain of 50 km stretch stretch between Jhansi and Lalitpur on National Highway no. 26 (NH‐26) as part of the North – South Corridor in Uttar Pradesh. The project road starts from 88.5 km of the Shivpur‐Jhansi Road of NH‐25 and ends at 46.10 km of NH‐26. This stretch of the project road is named UP2. The project extends from 46.10 km to 94.00 km of NH‐26 and is named UP3.The work involves strengthening and widening of existing 2 lane highway, construction of additional 2 lanes and provision of service roads in specific urban and semi‐urban areas to cater to local traffic. Total cost of project is Rs.4,060 mn which enjoys 20 years of concession period including construction period of 30 months. The project has commenced operations from FY11.

Final COD : The final completion certificate is issued by the indipendent consultant vide their letter dated 13th Novermber, 2017. The final completion date is 11th November, 2014

Major Maintenance Work : 1st Major Maintenance Work was completed in June, 2017 and completion certificate in this regard is issued by independent consultant.

Hyderabad Expressways Ltd

Hyderabad Expressways Limited is a Special Purpose Company promoted by Gayatri Projects Limited and Maytas Infra Limited to design, construct, develop, finance, operate and maintain 8-lane access controlled expressway under Phase II programme of outer ring road (ORR) of Hyderabad Urban Development Authority HUDA. HUDA has made up its mind for taking up development of outer ring road project where the intensity of traffic has increased significantly and there is requirement of providing access controlled corridor connecting areas like Cyberabad, International airport, Singapore Township, Bio‐Tech park etc. for safe and efficient movement of traffic. The project work starts from Bongulur to Tukkuguda casing 108 km to 121 km. The total cost of project is Rs.4,310 mn which enjoys 15 years of concession period including construction period of 30 months. The project has commenced operations from FY11.

Cyberabad Expressways Ltd

Cyberabad Expressways Ltd. CEPL is a Special Purpose Company promoted by annuity BOT project which GPL bagged with consortium company Maytas Infra Private Ltd. The project involves designing, construction, development, finance, operate and maintain of eight lane (AP II) access controlled expressway under Phase II programme of outer ring road ORR of Hyderabad Urban Development Authority HUDA. HUDA has made up its mind for taking up the development of outer ring road project where the intensity of traffic has increased significantly and there is requirement of providing access controlled corridor connecting areas like Cyberabad, International airport, Singapore Township, Bio‐Tech park etc. for safe and efficient movement of traffic. The project work starts from kollur to Patancheru casing 12 km to 23.70 km. The total cost of project is Rs.5,018 mn which enjoys 15 years of concession period which includes construction period of 30 months. The project has commenced operations from FY13.

Indore Dewas Tollways Ltd

Indore Dewas Tollways Ltd. IDTL is a Special Purpose Company promoted by GPL. GPL bagged the contract from NHAI with consortium company DLF Infra Holdings Ltd. The project involves Six – Laning of Indore – Dewas Section of NH-3 from KM 577.550 to Km 610.000 and Km 0.000 to Km 12.600 (Approximate Length 45.05 Kms) in the State of Madhya Pradesh under NHDP Phase – V to be executed as BOT (Toll) project on Design, Build, Finance, Operate and Transfer “DBFOT” Pattern. The total cost of project is Rs.6,000 mn which enjoys 25 years of concession period which includes construction period of 30 months. The Project has attained PCC on 29/05/2015

HKR Roadways Ltd

HKR Roadways Ltd. (HKRRL) is a Special Purpose Company promoted by GPL. GPL bagged the contract from Government of Andhra Pradesh with consortium company DLF Infra Holdings Ltd. The project involves Four – Laning of Hyderabad – Karimnagar – Ramagundam Stretch of SH – 1 (Rajiv Rahadari) Km 28.200 to Km 235.058 (Approximate Length 207 Kms) in the State of Andhra Pradesh to be executed as BOT (Toll) project on Design, Construction, Finance, Operation and Maintenance under Private Public Partnership on “DBFOT” Basis. The total cost of project is Rs.22,090 mn which enjoys 25 years of concession period which includes construction period of 30 months. The Project has achived provisional COD on 31st May, 2014 and started Toll collections from 1st June 2014.

Sai Maatarini Tollways Ltd

Sai Maatarini Tollways Ltd (SMTL) is a Special Purpose Company promoted by GPL. GPL bagged the contract from NHAI. The project involves Four-Laning of Panikoili-Rimuli Section of NH-215 from Km.0.00 to Km.163.00 (Design Length 166.173) in the State of Orissa under NHDP Phase – III as BOT (Toll) project on Design, Construction, Finance, Operation and Maintenance under Private Public Partnership on “DBFOT” Basis. The company has achieved provisional COD on 8th August 2017 and started toll collections from 17th August 2017
